Renovation Cost, Timeline, Budgeting & Complete Fit-Out Breakdown for Villas & Apartments in Dubai
Renovating a villa in Dubai has become more than a luxury upgrade—it is now one of the smartest ways to increase property value, improve functionality, and elevate your lifestyle. With rising demand for modern layouts, open-plan kitchens, premium joinery, and smart-home features, villa interior fit-out projects have reached record levels across communities like Dubai Hills, Palm Jumeirah, JVC, Emirates Hills, and Arabian Ranches.
But the biggest question every homeowner asks is:
“What is the real cost of villa interior fit-out in Dubai, and how long does the renovation actually take?”
This guide answers those questions with realistic numbers, community-specific insights, timeline expectations, approval considerations, and a full breakdown of how villa and apartment renovations are priced in 2026.
If you’re planning a villa renovation, apartment renovation, or full interior fit-out in Dubai, this article will help you build a clear, confident renovation budget—without surprises.
What Is Villa Interior Fit-Out in Dubai?
A villa interior fit-out covers everything needed to transform an existing property into a modern, functional, aesthetically aligned living space. It includes:
- Space planning
- Structural modifications
- Interior design
- Custom joinery
- Flooring
- Kitchens & bathrooms
- MEP works (Mechanical, Electrical, Plumbing)
- AC upgrades
- Lighting design
- Finishes & furnishings
In Dubai, villa fit-out projects often include:
- Open-plan kitchen conversions
- Adding glass rooms, extensions, pergolas
- Converting maid’s rooms into utility spaces
- Smart-home system installation
- New bathrooms with premium fittings
- Wall demolitions & floorplan reconfiguration
Because communities like Dubai Hills, Palm Jumeirah, and Arabian Ranches have different developer rules, renovation cost and timelines vary—a major reason homeowners get confused.
Villa Interior Fit-Out Cost in Dubai (2026 Update)
Villa renovation cost in Dubai depends on:
- Property size
- Scope of transformation
- Material selection
- Joinery scope
- MEP & AC requirements
- Authority approvals
- Community expectations
- Developer guidelines (Emaar, Nakheel, DDA, DM, etc.)
Below is the 2026 villa renovation cost guide based on real market averages:
1. Villa Renovation Cost by Property Type
Standard / Mid-Range Villas
AED 250,000 – 450,000
For villas in:
- JVC
- Jumeirah Village Triangle
- The Springs
- The Meadows
- Mudon
- Reem
Includes:
- Painting
- Lighting
- Basic bathrooms
- Mid-range kitchen
- Vinyl / porcelain flooring
- Wardrobes & feature walls
Premium Villas (Dubai Hills, Arabian Ranches, JGE)
AED 350,000 – 850,000
Includes:
- New kitchen + appliances
- Full bathroom upgrades
- AC ducting adjustments
- Premium joinery (walnut / oak veneers)
- Larger area reconfigurations
- Marble or large-format tile flooring
- Smart-home upgrades
Ultra-Luxury Villas (Palm Jumeirah, Emirates Hills, Al Barari)
AED 800,000 – 3,500,000+
Includes:
- Structural changes
- Bespoke joinery throughout
- Imported marble
- High-performance AC systems (VRV/VRF)
- Architectural redesign
- Pool + landscaping integration
- High-end automation & lighting systems
Luxury communities demand higher specifications, resulting in a 35–50% natural price increase.
2. Apartment Renovation Cost in Dubai (2026)

Apartments cost less overall, but more per square foot due to logistics and building restrictions.
1 Bedroom: AED 100,000 – 150,000
2 Bedroom: AED 130,000 – 200,000
3 Bedroom: AED 200,000 – 1,000,000
Cost drivers:
- Limited working hours
- Building permissions
- Chiller & AC system restrictions
- Shared shaft limitations

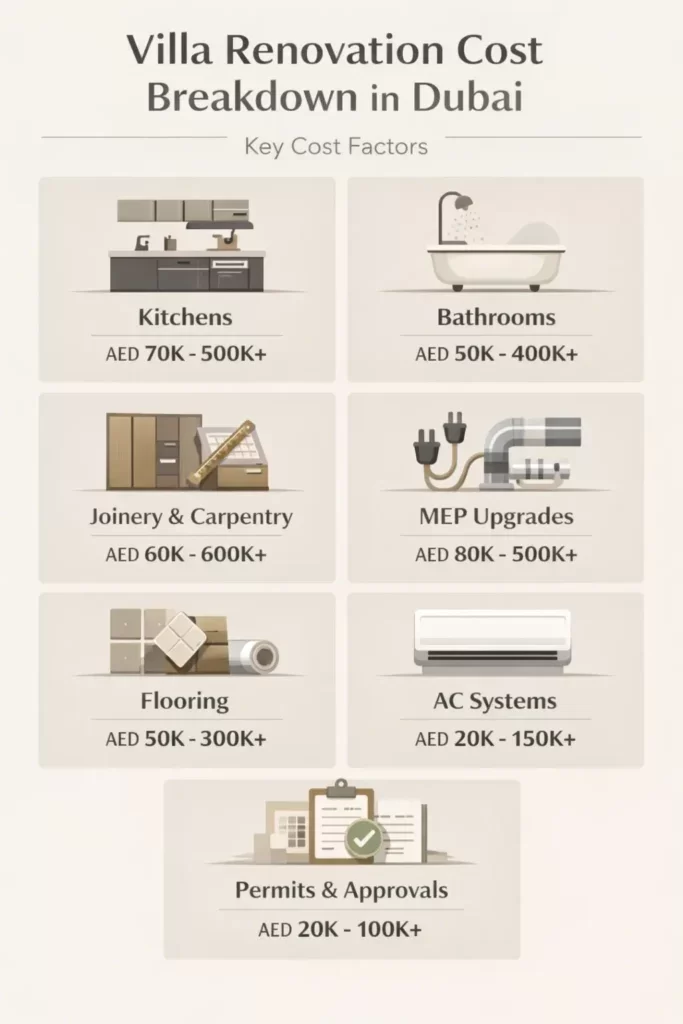

3. Detailed Cost Breakdown: What Drives the Budget?
Below is a complete Dubai-specific breakdown that other articles fail to include clearly:
A. Kitchen Renovation Cost
- Basic: AED 25,000 – 55,000
- Mid-range: AED 55,000 – 130,000
- High-end: AED 130,000 – 500,000+
Cost depends on:
- Cabinet material
- Countertop (quartz / marble)
- Appliances (Siemens / Gaggenau / Miele)
- AC routing
- Plumbing shifts
B. Bathroom Renovation Cost
- Small bathrooms: AED 15,000 – 35,000
- Medium bathrooms: AED 35,000 – 75,000
- Luxury bathrooms: AED 75,000 – 180,000+
Factors:
- Tile selection
- Sanitaryware brand
- Waterproofing
- Hidden mixers
- Walk-in shower installation
C. Flooring Cost (Material + Fixing)
- Ceramic tiles: AED 50 – 120 per sqm
- Porcelain tiles: AED 100 – 850 per sqm
- Engineered wood: AED 180 – 450 per sqm
- Marble: AED 350 – 1500 per sqm
Cutting + leveling charges separate.
D. MEP, Electrical & AC Works (The Hidden Cost)
These often surprise homeowners.
- Basic AC servicing: AED 5,000 – 10,500
- Full VRV/VRF replacement: AED 80,000 – 600,000
- Electrical rewiring: AED 20,000 – 400,000
- Plumbing replacement: AED 15,000 – 300,000
These are essential for older villas—especially pre-2010 builds.
E. Joinery & Custom Woodwork (Major Cost Factor)
Dubai’s villas heavily rely on custom joinery.
- Basic wardrobe: AED 10,000 – 20,000
- Premium wardrobe: AED 15,000 – 35,000
- Walk-in closets: AED 35,000 – 120,000+
- Kitchen joinery: AED 35,000 – 300,000+
- Feature walls & paneling: AED 4,000 – 25,000+ per wall
Joinery quality instantly defines a villa’s luxury level.
Villa Interior Fit-Out Timeline in Dubai (2026)

A realistic timeline is:
1. Consultation & Site Assessment – 1 Week
Understanding vision, layout issues, and renovation goals.
2. Concept Design & Budgeting – 2–4 Weeks
Mood boards, space planning, material alignment, cost clarity.
3. Detailed Drawings, Approvals & NOCs – 3–8 Weeks
Depends on community:
- Emaar: Fastest
- Nakheel: Most strict
- Dubai Hills: Highly detailed
- DDA/DM approvals: Technical and slow
4. On-Site Execution – 2–9 Months
Depending on scope:
- Light makeover: 6–10 weeks
- Full renovation: 4–7 months
- Full strip-out + redesign: 7–12 months
5. Snagging & Handover – 1–3 Weeks
Hidden Costs Most Homeowners Don’t Expect
This is where many articles go wrong—they omit the reality.
- Authority approvals (AED 3,000 – 25,000)
- Structural engineer reports (AED 10,000 – 30,000)
- Developer NOC fees (AED 1,500 – 6,000)
- Waste removal
- Chiller line modifications
- Parking permissions
- Logistics fees
A professional contractor must disclose these upfront.
Renovation Budgeting Strategies to Save Money
1. Prioritize high-impact spaces
- Kitchen
- Living room
- Master bathroom
These areas deliver maximum ROI.
2. Avoid cheap joinery
Low-quality joinery fails in humidity and AC-heavy Dubai homes.
3. Use local materials where possible
Imported marble and veneer increase cost + lead time.
4. Plan lighting early
Lighting mistakes cause rework, cost increase, and ceiling issues.
5. Opt for phased work if needed
Better than compromising with low-quality finishes.
Villa Interior Fit-Out Process: Step-by-Step Guide

1. Initial Consultation & Vision Mapping
Lifestyle study, problem identification, design brief.
2. Design Development
3D renders, material board, layout options.
3. Technical Documentation
MEP drawings, elevations, structural review.
4. Budget Finalization
Transparent BOQ (Bill of Quantities).
5. Authority Approvals
Emaar, Nakheel, DDA, DM, Trakhees, etc.
6. On-Site Construction & Fit-Out
Civil works → MEP → Ceiling → Joinery → Flooring → Paint → Installations.
7. Snagging
Quality checks, corrections.
8. Final Handover
Warranties, manuals, and maintenance guidance.
Choosing the Right Contractor: What Matters Most in Dubai
Homeowners should look for:
- In-house design + joinery + MEP
- Transparent costing
- Understanding of community rules
- Experience with your villa type
- Structured project management
- No reliance on subcontractors
- Case studies + real reviews
Firms with integrated capabilities reduce:
- Mistakes
- Delays
- Budget fluctuations
- Miscommunication
This is where top design-build companies outperform traditional contractors.
Final Thoughts: Renovating Your Villa in Dubai in 2026
Villa interior fit-out is not just about flooring and paints—it is a complete transformation of how your space looks, feels, and functions. Dubai’s premium villas require a structured approach with strong design vision, precise MEP coordination, and high-quality joinery.
Whether you are upgrading a villa, townhouse, or apartment, the key factors that shape your renovation cost, timeline, and experience are:
- Scope
- Material selection
- Contractor expertise
- Approvals
- Community requirements
- Quality of execution
A professional design-build partner ensures the project moves from concept to completion smoothly, with full accountability and no hidden variations.
FAQ — Villa Interior Fit-Out & Renovation in Dubai (2026)
1. What is the cost of villa renovation in Dubai?
Villa renovation cost in Dubai ranges from AED 250,000 to AED 3,500,000+, depending on villa size, materials, joinery scope, MEP upgrades, and community regulations.
2. How long does a villa interior fit-out take in Dubai?
Most villa fit-out projects take 4 to 12 months, depending on whether it’s cosmetic, full strip-out, or structural renovation.
3. What factors impact renovation cost the most?
The biggest cost drivers are:
-
Kitchens & bathrooms
-
Custom joinery
-
MEP & AC upgrades
-
Structural modifications
-
Developer/authority approvals
-
Quality of finishes
4. Do I need approvals for villa renovation in Dubai?
Yes. Most communities (Emaar, Nakheel, Dubai Hills, DM, DDA, Trakhees) require approvals for:
-
Structural changes
-
MEP modifications
-
Floor plan adjustments
-
External works
5. What is the difference between renovation and interior fit-out?
Fit-out focuses on interiors (finishes, joinery, flooring, lighting).
Renovation can include both interiors and structural/MEP upgrades, making it a more extensive transformation.
6. Are apartment renovations cheaper than villa renovations?
Total cost is usually lower, but cost per square foot is higher due to logistics, access limitations, and strict building rules.
7. Which areas of a villa give the highest ROI when renovated?
In Dubai, the top value-boosting areas are:
-
Kitchen upgrades
-
Master bathroom
-
Flooring
-
Living room layout improvements
-
Joinery enhancements
8. What hidden renovation costs should I expect?
Unseen costs often include:
-
Developer NOC fees
-
Authority approvals
-
Electrical load upgrades
-
Material lead times
-
Snagging & rework
9. Can I reduce my renovation budget without sacrificing quality?
Yes. Smart strategies include:
-
Phased renovation
-
Local material alternatives
-
Prioritizing high-impact spaces
-
Avoiding unnecessary structural changes
10. Should I hire one company for design & build?
Using a single integrated design-build firm reduces delays, improves communication, and ensures cost control—especially for large villa projects.
